Seminole County ePlan Permit Guide: ProjectDox, Plan Review Corrections & Timelines

Seminole County Florida Development Services webpage showing E-Plan Review information.

Seminole County’s electronic permitting process can look simple at first: upload the plans, wait for review, and respond if the County asks for changes. In practice, many delays happen because homeowners and contractors do not know which ProjectDox task is active, which department has the project, what an unresolved review comment means, or what must be done after revised files are uploaded.

I prepared this guide from the perspective of someone who works with permit drawings and plan-review corrections. The goal is to explain the Seminole County ePlan process in practical language, show what the main ProjectDox screens mean, and help you identify when a correction is a drafting issue, a zoning issue, an engineering issue, or simply an incomplete portal task.

If you already know you need drawings for a Seminole County property, visit our Seminole County Site Plans & Permit Drawings page. If you already have reviewer comments, see Florida Permit Corrections & Resubmittals.

What Is Seminole County ePlan / ProjectDox?

Seminole County uses an electronic plan-review environment commonly referred to as ePlan, ProjectDox, or ProjectFlow. It is used to receive project documents, route plans to reviewing departments, record comments, manage correction cycles, and maintain the file history for permit applications.

Seminole County Florida Development Services webpage showing E-Plan Review information.
Seminole County Development Services provides the County’s ePlan and electronic plan-review information.

Useful official starting points include the Seminole County Building Division, the ePlan / ProjectDox login, and the County’s ePlan video tutorials.

How the Seminole County Permit Process Works

1. Determine the Required Drawing Scope

Before drafting starts, determine whether the project requires only a site plan or a coordinated permit set. A fence, driveway, pool, detached garage, addition, new residence, tenant improvement, and commercial alteration can all have different submittal requirements.

A detached garage, for example, may require a site plan, floor plan, elevations, foundation details, framing information, electrical drawings, and structural engineering. A simple fence may require much less. Starting with the wrong scope is one of the easiest ways to create an avoidable correction cycle.

If you are still trying to identify the likely scope, use our Florida Permit Requirements Checker.

2. Start the Permit Application

The applicant starts through Seminole County’s online permitting process and receives the project/application information needed for electronic review. Contractors should confirm their licensing information is current in the County system. Owner-builders should follow current County owner-builder identity and application requirements.

3. Upload the Required Documents and Drawings

Once the project enters ePlan, the applicant uploads the required PDFs into the proper drawing or document folders. The package must be complete enough for review. Uploading one drawing while required forms or supporting plans are missing does not create a review-ready submission.

4. Complete the Applicant Task

This is one of the most important parts of the process. Uploading files is not always the same as completing the task. When ProjectDox assigns an applicant task, completing that task is normally what tells the reviewing agency the package is ready for the next action.

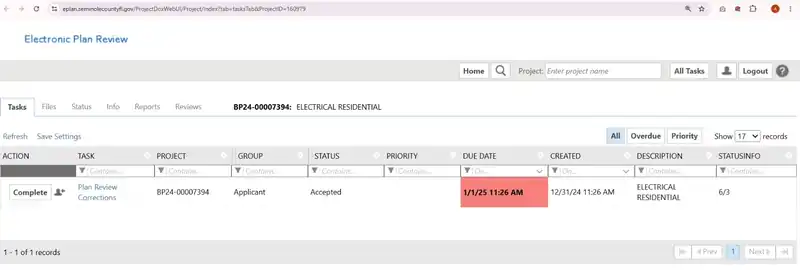

Seminole County ePlan ProjectDox Tasks tab showing a Plan Review Corrections task and applicant status.
Example of the ProjectDox Tasks tab. Always confirm that the required applicant task has actually been completed after files are uploaded.

Understanding the Main ProjectDox Tabs

TabWhat It ShowsWhat You Should Check
TasksActions assigned to the applicant/project teamIs anything waiting for you? Is a correction task accepted but not completed?
FilesUploaded drawings, documents, and resource foldersAre the correct files in the correct folder? Did the replacement file upload correctly?
StatusReview progress, time, and unresolved review itemsIs the project with the jurisdiction or the applicant?
InfoPermit/project informationConfirm project number, address, description, and current status.
ReportsDetailed workflow and project recordsUse reports when the dashboard does not explain the project history.
ReviewsReviewer comments by department and cycleWhich comments are unresolved and which discipline must respond?

The Files Tab: Version Control Matters

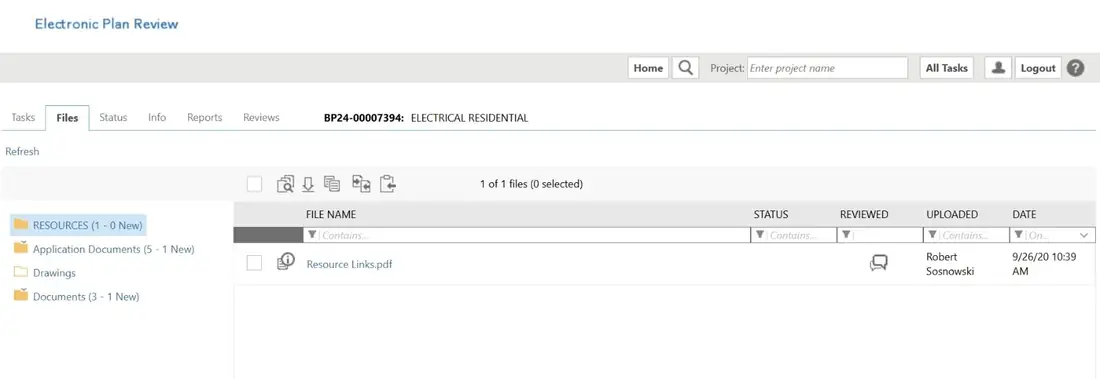

Seminole County ePlan Files tab showing project document folders and a Resource Links PDF.
The Files tab stores project drawings and documents. Revised files should follow the County’s current file-naming/versioning procedure.

ProjectDox is designed to maintain file history. When a reviewed drawing is corrected, the revised file is generally uploaded using the same filename as the file it replaces when that is required by the County’s workflow. Randomly adding words such as “FINAL NEW REV 2” can interfere with versioning.

The Status Tab: Who Actually Has the Project?

Seminole County ePlan Status tab showing time with jurisdiction, time with applicant and unresolved review comments.
The Status tab can distinguish time with the jurisdiction from time with the applicant.

A permit may have been open for a long period without spending that entire period in active County review. If the project has spent months waiting on an applicant correction task, the total age can be misleading. Before assuming the County is delaying the permit, check who owns the active task, how much time is shown with the applicant, and how many comments remain unresolved.

The Info Tab: Confirm the Permit Record

Seminole County ePlan Info tab showing permit project details and Plan Review Corrections status.
The Info tab provides the project number, description, location, owner, and current status.

When you hire a drafter, engineer, electrician, architect, or permit consultant to help with a correction, send the correct project number, address, and the exact current reviewed drawing set.

The Reports Tab: Detailed History

Seminole County ePlan Reports tab showing available ProjectDox permit review reports.
The Reports tab can provide deeper project history, including uploaded files, review status, discussions, and logged events.

The Reviews Tab: Where the Technical Work Begins

Seminole County ePlan Reviews tab showing electrical and zoning plan review comments.
Reviewer comments may come from several disciplines. Each comment should be assigned to the correct drawing, consultant, or licensed professional.

A single project can receive comments from electrical, zoning, building, structural, plumbing, mechanical, addressing, flood, and other groups. Each comment should be classified before revisions begin.

Comment TypeTypical Responsibility
Site / zoningSetbacks, use, accessory structures, lot coverage, easements, and site layout
ArchitecturalFloor plans, elevations, sections, dimensions, openings, and scope coordination
StructuralFoundation, framing, beams, posts, connections, uplift/load path, and calculations
ElectricalService, riser, panel, loads, devices, grounding/bonding, and required equipment
Mechanical / plumbingEquipment, ducts, water, waste, venting, risers, and fixture information
AdministrativeForms, signatures, file naming, digital certificates, and missing documents

If you already have comments, use our Florida Permit Rejection Analyzer to organize them before requesting revisions.

Seminole County Permit Review Timeline

There is no single timeline for every permit. Review duration depends on permit type, completeness, reviewing departments, County workload, and whether corrections are required.

Seminole County’s residential guidance has published planning estimates for certain new-structure workflows. Treat these as estimates, not guarantees:

Review StagePlanning Estimate
Application submittal processingAbout 1 business day
Addressing, if requiredAbout 1-2 business days
ZoningAbout 1-2 business days
Flood review, if requiredAbout 1-2 business days
Wetlands review, if requiredAbout 2-3 business days
Building plan reviewAbout 7-10 business days

Several reviews can occur concurrently, so do not simply add every number together.

Florida Permit Review Deadlines and the 10-Business-Day Correction Rule

Florida Statute 553.792 also establishes review periods for complete and sufficient applications. The applicable period depends on permit category and size. For the written deficiency notice process described by the statute, the notice includes a 10-business-day period to submit revisions, with related review requirements after timely revisions are received unless an applicable exception or agreed extension applies.

Do not assume every note visible in ProjectDox automatically creates the same statutory deadline. Follow the actual written notice and due date for your permit. See Florida Statutes Chapter 553.

How to Respond to Seminole County Plan Review Corrections

  1. Read every comment before editing.
  2. Separate comments by discipline.
  3. Match each comment to the sheet or document that must change.
  4. Revise the actual drawing. A response-box explanation is not a substitute for missing plan information.
  5. Clearly identify revisions where appropriate.
  6. Write concise responses identifying the sheet and what changed.
  7. Upload the corrected files using the correct naming/versioning procedure.
  8. Complete the Plan Review Corrections task.

Example of a Good Reviewer Response

Reviewer comment: Please provide a riser diagram showing conductor sizes, types, quantities, and overcurrent devices.

Response: “Revised Sheet E-2 to add the electrical service/riser diagram with conductor sizes, conductor type, quantities, and associated overcurrent protection.”

Common Reasons Seminole County Plans Receive Comments

AreaCommon ProblemTypical Fix
Site planMissing setbacks, dimensions, boundaries, or proposed work locationRevise the site plan using reliable property information and clearly dimension the work
ZoningUse or accessory structure is not clearly permitted/locatedClarify use, zoning data, and placement
ArchitecturePlans, elevations, and sections do not coordinateRevise affected sheets so dimensions and scope agree
StructureInsufficient footing, beam, connection, or load-path informationAdd structural details/calculations and PE review when required
ElectricalMissing riser, service, load, panel, or equipment informationRevise electrical drawings with required service information
FloodElevation/flood-zone information is incompleteCoordinate BFE/DFE/FFE and required flood documentation
Portal / documentWrong filename, missing form, or unacceptable digital signatureCorrect the document issue and resubmit properly

When a Florida PE May Be Required

Not every Seminole County permit requires a Professional Engineer. Projects involving structural design, foundations, framing systems, engineered connections, retaining walls, drainage, certain commercial work, or other engineering responsibility are more likely to require review by a Florida-licensed engineer.

A PE seal is not simply a sticker added after drafting. The engineer taking responsibility must be able to review the design and supporting information. That may require calculations and plan revisions.

Site Plans FL can coordinate Florida engineering review for qualifying scopes. See our Florida PE Stamp & Site Plan Guide.

Digital Signatures: Why a Legitimate PE Seal Can Still Fail ePlan

A drawing can be professionally prepared and reviewed by a licensed engineer but still fail electronic portal validation if the PDF does not meet the County’s digital-signature requirements. Seminole County provides specific guidance for design professionals using electronic plan review, including certificate-based digital signing.

A pasted image of a seal/signature is not the same thing as a verifiable digital certificate. See Seminole County Digital Signature Information.

What Homeowners Need to Know

Homeowners usually save the most time by answering three questions before the first upload:

  • What permit type applies to the work?
  • What drawings are required for that project type?
  • Does any part of the design require licensed professional engineering?

Do not assume a small project means “site plan only.” GIS and aerial mapping can support research, but they do not replace a licensed survey when certified boundary, topographic, or elevation information is required.

What Contractors Need to Know

For contractors, one of the biggest risks is coordination. Architectural, structural, and MEP drawings must describe the same project. If one discipline changes a wall, opening, equipment location, or support condition, the affected sheets should be coordinated before resubmittal.

  • Give every consultant the same current review set.
  • Maintain clear revision dates.
  • Confirm one discipline’s changes do not conflict with another.
  • Do not upload partial revisions when comments affect multiple sheets.
  • Complete the applicant task only after the package is actually ready.

How Site Plans FL Can Help With Seminole County ePlan

Site Plans FL works with homeowners, contractors, builders, developers, and businesses that need Florida permit drawings prepared, coordinated, or revised.

For a new project, send the property address, project type, survey if available, and any sketches or existing plans. For a project already in corrections, send the complete review comments and the exact plan set reviewed by the County.

We can then determine whether the next step is site-plan drafting, architectural revisions, structural engineering, MEP corrections, drainage work, Florida PE review, or a coordinated permit resubmittal.

Site Plans FL Services

ServiceTypical Use
Site / Plot PlansProperty layout, structures, setbacks, dimensions, lot coverage, and improvements
Architectural Permit DrawingsFloor plans, elevations, roof plans, sections, schedules, and details
Structural Plans & CalculationsFoundations, framing, beams, posts, connections, uplift/load path, and calculations
MEP Permit DrawingsElectrical, plumbing, and HVAC permit documentation
Permit CorrectionsReviewer comments, revised sheets, and resubmittal packages
Drainage / GradingElevations, runoff direction, swales, and site drainage information
Flood-Zone CoordinationBFE/DFE/FFE, NAVD88, and flood-related drawing coordination
Florida PE ReviewEngineering review and signed/sealed documentation where required

See our full Florida permit drawing services directory.

Site Plans FL Starting Pricing

These are current published starting prices. Final pricing depends on the property, required drawings, permit comments, flood/drainage conditions, engineering responsibility, and number of disciplines involved.

ServiceStarting Price
Basic Site Plan$89
Pool / Garage / Addition Site Plan$149
ADU / Detailed Site Plan$249
Permit Corrections$100
Septic & Well Coordination$250
Florida PE Review – limited/simple scope$350
Flood-Zone Site Plan$350+
MEP – single discipline$350-$750+
Deck Permit Set$450+
Architectural Permit Drawings$500+
Drainage / Grading Plans$500+
Structural Permit Drawings$750+
Complete multi-discipline permit packageCustom quote

For a planning estimate, use our Site Plans Cost Calculator.

Why Choose Site Plans FL?

Permit drawings are not successful because they contain more notes. They are successful when the information a reviewer needs is clear, coordinated, and placed on the correct sheet.

Our review focuses on the same questions a plan reviewer is trying to answer: Where is the proposed work? Is the scope clear? Do dimensions and elevations coordinate? Is the structural load path understandable? Are calculations required? Do architectural, structural, and MEP plans agree? Has each reviewer comment been addressed on the actual drawing?

Seminole County Development Services Contacts

ContactInformation
Development Services1101 E. First St., Sanford, FL 32771
Building Division407-665-7050
Building customer serviceBPCustomerService@seminolecountyfl.gov
Planning & Development407-665-7371
Typical public office hoursMonday-Friday, 8 a.m.-5 p.m.

Always verify current contact information and project-specific requirements on the Seminole County Development Services website.

Frequently Asked Questions

Is ProjectDox the same as Seminole County ePlan?

ProjectDox is the electronic platform used within Seminole County’s ePlan workflow. County materials may also use terms such as ePlan and ProjectFlow.

How long does Seminole County plan review take?

It depends on permit type, completeness, and workload. County guidance for certain residential workflows has shown approximately 7-10 business days for building plan review, with zoning, flood, or wetlands reviews occurring as applicable. Treat those as estimates, not guarantees.

Why is my permit not moving after I uploaded revised drawings?

Check the Tasks tab. A Plan Review Corrections task may still need to be completed after the replacement files are uploaded.

Should I rename corrected drawings?

Follow the current ProjectDox applicant instructions. When ProjectDox is versioning an existing reviewed drawing, revised files are generally expected to use the same filename so the system can create the next version.

What does “Time with Applicant” mean?

It indicates time when the project was waiting for an applicant action rather than active jurisdiction review.

Can Site Plans FL respond to Seminole County comments?

We can prepare revised drawings, correction-response information, and coordinated resubmittal documents within the agreed scope. Portal submission normally remains with the applicant, contractor, or authorized representative.

Does every Seminole County project need a Florida PE stamp?

No. Engineering requirements depend on project type and design responsibility.

Why can a legitimate PE-signed plan still fail electronic validation?

The portal can have certificate-verification requirements for digital signatures. A valid engineering design does not automatically mean every PDF signing method meets Seminole County’s electronic-document requirements.

Can GIS replace a survey for a site plan?

No when the County requires certified boundary, topographic, or elevation information. GIS and aerial imagery are useful research tools, but they do not replace a licensed survey where one is required.

What should I send Site Plans FL for a correction quote?

Send the project address, permit/project number, complete review comments, exact reviewed drawings, and any survey, calculations, or supporting documents already submitted.

Need Help With a Seminole County Permit?

If you have not submitted yet, send us the property address, project type, survey, and any existing plans. If the project is already in ePlan corrections, send the review comments and the exact reviewed drawing set.

We can help identify whether the next step is a site plan, architectural revision, structural engineering, MEP correction, Florida PE review, or coordinated permit resubmittal.

Get Seminole County Site Plan Help   |   View All Florida Permit Drawing Services

Site Plans FL / Site Plans LLC
Call / WhatsApp: +1 (321) 359-3465
Email: drafting@siteplansfl.com

Get a Free Estimate

Fill out the form below and we’ll contact you within 24 hours to discuss your needs.
Engineer Malik from Site Plans FL

Engineer Malik leads Site Plans FL, helping homeowners, contractors, and businesses prepare permit-ready site plans, PE stamped drawings, and drafting support across the United States.

Need a residential, commercial, or PE stamped site plan in Florida? Site Plans FL is here to help. Whether you are applying for a building permit, pool permit, fence permit, driveway permit, or commercial approval, our team provides fast and accurate permit-ready site plans prepared for Florida property owners and contractors.

Engineer Malik from Site Plans FL

Author

Engineer Malik

Founder & CEO @ Site Plans Online USA | Site Plans FL | Civil Engineer · 11 Years · 1,000+ Permit Drawings Approved Serving All 50 States | Florida Specialist

I have been preparing permit drawings since 2015. Eleven years. More than 1,000 approved projects across the USA, UK, and international markets. I have seen every reason a building department sends back a correction notice — and I know how to make sure they don’t.

In 2021, I founded Site Plans Online USA (siteplans.online) — a remote drafting service that prepares permit-ready site plans for homeowners, contractors, and pool companies across all 50 states. No site visit needed. No survey required. Delivered as a permit-ready PDF in 12–24 hours. Starting from $79.
